Contact Email

My contact email: 1tgoding@gmail.com

Sunday, February 4, 2024

Cabin Deck Top Construction





The top deck construction involves installation of Carlins, Cleats, Dorade Boxes, Electrical, Top Deck and yes, a couple of Mods.


I decided to beef up the two 18mm x 25mm upper longitudinal carlins between BH2 and BH3 to 20mm x 30mm. I'm using Hoop Pine for the carlins but have not yet decided whether I will paint or lacquer them. Whatever I decide I will carry on that theme to the three cleats located on the top edges of BH2 and the two cleats on the rear cabin wall.





Cardboard templates are made for the cleats and traced onto the Hoop Pine.




The upper carlins and forward cabin cleats are installed.



There are some tricky angles required for the cleats to ensure a neat finish. The inside edges are routed, and the cleats are sanded to a fine finish prior to installing.




The aft cabin cleats are glued in place.






The Starboard Dorade Box is stitched in place and epoxy tack welded.








The Port Dorade Box is stitched
 in place and epoxy tack welded.











The Dorade Boxes are filleted and glassed for strength.










The Dorade Box cleats are shaped and 2 pieces of 9mm ply are glued together for the backing blocks.






For additional strength I added two strips of glass tape to the inside where the backing blocks will be installed. The tape ran from BH 2 completely around the Dorade Box to the hull side.








The backing blocks are glued and temporarily screwed in place.









The last three things (hopefully) to do before installing the cabin roof which will close up the Dorade Boxes is:
1) Drill for drainage and
2) Provide waterproof access for electrical wires to connect the navigation lights and the solar panel.
3) Glue the Dorade Box cleats.







The drainage holes are drilled out with a 25mm Forstner bit. A 25mm diameter electrical conduit is roughened up with 40 grit sandpaper and epoxied into place.











When set hard the conduit is cut off and sanded smooth leaving a smooth waterproof drainage hole from the Dorade box.







25mm conduit is also glued into the forward deck top and secured to the backing block. This will allow wiring to travel up from the electrical panel and prevent water entering the forward cabin storage area.








And finally, the cleats are glued in place.









NEXT





I decided to install 2 Butterfly Vents on BH2 for the Dorade Box ventilation.











I drew the Butterfly Vent dimensions onto a 25mm thick piece of Hoop Pine and using a Japanese saw rough cut the section.








I used a 102mm hole saw to cut the opening for the vent, remember this is still a 25mm thick piece of Hoop pine.








Using a belt sander secured in a homemade bench jig I shaped the piece.







After marking the center, I drew
a pencil line around the ring dividing the piece into two 12.5mm thick sections.









Using a Japanese saw I cut the piece into the two separate halves.







A fine rebate was routed to allow the vents to sit flush, and mounting holes drilled.









Now it's time to make it looked pretty, firstly a coat of undiluted epoxy.










After several coats of polyurethane, the unit is screwed to BH 2.











Here is a pic taken from the top of the dorade box. I intend to cover the vent with some flyscreen. Gota keep them pesty mossies, sand fly's and wasps out.








Four stirrer stickers glued together in a square for the frame and fly screen glued to the frames……simple.












Screens installed, I think that completes the Dorade box, ready for painting.







After reading previous builders posts, I'm going to strengthen the area between the upper carlins on BH2, (a high stressed area where the tabernacle secures to BH2). I intend to make it structural, functional and pleasing to the eye.




I drew a rough pencil line of the shape on BH2.






A copy of the rough line drawing from BH2 is transferred to transparent wax paper and using the curved radius of a 4lt paint tin and a compass I drew the lines with a more pleasing curve. Using carbon paper, I transferred the design onto a nice, grained piece of 9mm ply.

The three circles are where a clock, barometer and hygrometer/thermometer will be installed.


These are the instruments I will be installing.



The 9mm ply is cut and trial fitted to BH2. This piece in conjunction with the upper cabin cleat will give additional strength to BH2.






 I cut the upper cleat from a solid piece of Hoop Pine and followed the curves of the
instruments.






Here is the upper cleat fitted to the 9mm ply, edge routed and sanded should look very nice BUT.........I think it can be made to look nicer.



I decided to follow the laminated theme using the Blue Gum, yes more time-consuming work but it will look very nice inside the cabin.


I calculated the cuts for the laminations of alternating white Hoop Pine and Blue Gum that would evenly fill the upper cleat. This pic shows the two cuts in preparation for the lamination.




7mm thick Blue Gum strips are cut.




The
sections are coated with epoxy and clamped together. A plastic sheet is placed under to prevent the piece sticking to the board.










The upper cleat will be left for 24 hrs. to set hard.










Time to clean up, I used 60 grit paper on an orbital sander.






Cleaned up in no time, looking nice.



A couple of coats of epoxy are applied before lacquering.





While waiting for the epoxy to dry I cut the two cabin top sheets from 6mm ply.










The two sheets are glued together in the middle with the butt block.












































Monday, January 29, 2024

Laminated Upper Breast Hook

Here I go again another Mod.

Laminated Upper Breast Hook

 I decided to construct a laminated upper breasthook. Yes, as a retired old man I do have too much time on my hands, but the upper breasthook is a visually appealing section of the bow so let's make it a beautiful feature.

I used a combination of two contrasting-colored timbers, a red hardwood called Blue Gum (yes, a red colored timber called blue gum, go figure!) and a light-colored timber called Queensland Hoop Pine. I am also using the Blue Gum on the rub rails and Hoop Pine for the sheer rails, spars and cabin flooring so the timber types and colors will flow throughout the rest of the build.

I laminated the sections in situ on the build using plastic over the forward sheer clamps to prevent the breast hook from sticking to the sheer rails and the pieces held in place with clamps until the resin hardened.


When cured the breasthook will be shaped, routed and sanded prior to final fixing.





The laminated section is removed ready for sanding.











The breasthook is sanded top and bottom and the aft end is routed, its looking very nice.








The bottom is given a good saturation of epoxy prior to installation. The epoxy brought out the contrasting colors, I can't wait to see the upper surface when several layers of lacquer are applied. The astute may have noticed the groove in the bottom of the blue gum.... yes, what once was a floorboard is now a breasthook.







The unit is temporarily held in place with a single clamp and four 38mm SS screws.

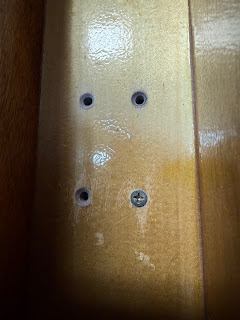

Prior to gluing in place, I inserted 4 wires through the hull side into the screw holes. This is to ensure the holes line up and prevent splitting the timbers if the screw hole is missed.











The epoxied unit is clamped and screwed in place and left for a couple of days to set hard.








The breasthook is sanded down level with the sheer clamps and hull topsides, I think it turned out really nice. I can't wait to see the finished section when lacquered.
